Scope Management: Why Scope Needs More Than Four Pages

And why good scope is more than a document

The Story That Changed Everything

I learnt this lesson the hard way. Early in my career, I worked on a major track renewal at one of London's busiest sub-surface stations. The window was Christmas. The station had to reopen for Boxing Day services and New Year crowds. No slippage. No second chances.

Real-world constraints don't get much tighter than that.

Our scope document? Four pages, half of it was formatting.

Everyone nodded it through early on, and we moved at pace. Only weeks before delivery did we realise what we'd actually missed. We knew about the civils, sure. But the associated electrical works in the subways? Completely overlooked. Lighting, PA systems, advertising displays - these aren't nice-to-haves. You can't reopen a subway without lighting, and we couldn't hand over until everything incuding: lighting, PA, advertising - was back up and working.

We were asked how we'd missed it. The honest answer: we didn't break the scope down far enough, and the four-pager was filed away after kickoff and never properly built up as the project evolved.

That day taught me a simple truth: get scope nailed down, structure it clearly, and keep it actively updated, or you'll pay for it later.

Why This Actually Matters

PMI's Pulse of the Profession 2018 research shows that 52% of all projects face scope creep (p. 7). But here's what that actually means in the real world - half your projects will quietly grow beyond what was agreed, eating time, budget, and quality. Often without anyone noticing until it's too late.

That's why scope matters. It's how you turn an idea into something real. It keeps the team focused, avoids wasted effort, and reduces the chance of nasty surprises that delay work or increase costs. Without clear scope, good teams can end up doing the wrong work really well. With clear scope, even a stretched team can still deliver what matters.

What Scope Management Really Is

According to the APM Body of Knowledge (7th Edition), scope covers three things: what you'll deliver (outputs), the change those outputs enable (outcomes), and the work needed to make it happen. But let me break that down in plain English.

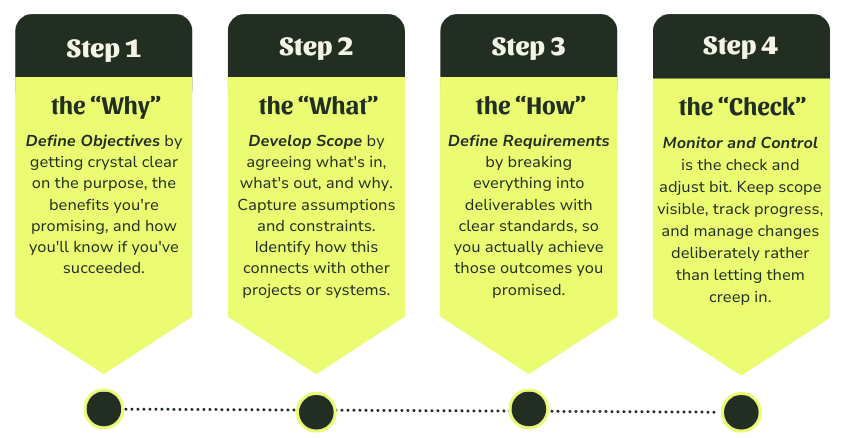

Think of it as four connected pieces:

Define Objectives is the why. Get crystal clear on the purpose, the benefits you're promising, and how you'll know if you've succeeded.

Develop Scope is the what. Agree what's in, what's out, and why. Capture your assumptions and constraints. Identify how this connects with other projects or systems.

Define Requirements is the how well. Break everything down into deliverables with clear standards, so you actually achieve those outcomes you promised.

Monitor and Control is the check and adjust bit. Keep scope visible, track progress, and manage changes deliberately rather than letting them creep in.

Here's an analogy that might help: planning a home extension. You define the objective (need more space for the family), develop the scope (which rooms, what's excluded), define requirements (the quality standards and design details), then monitor and control by checking progress and approving any changes before they happen.

Get clarity on all four at the start, and keep checking them as the project develops. It makes decisions faster and cuts the risk of missed work or unexpected changes catching you off guard.

A Process That Actually Works

Define Objectives: Set the Direction

This is your why. The purpose of the project, the change you're aiming for, and the benefits it should bring. Before you get going, nail down the purpose. What are we trying to change, for whom, and how will we know it worked?

In most organisations, this starts with something formal: business case, project charter, board approval. So everyone agrees on the destination.

Example: Reduce passenger wait times on a metro line by 15% within 12 months through track improvements and better scheduling.

Whether you're running waterfall or agile, this foundation stays constant. In waterfall, objectives get locked early with formal change control. In agile, they can evolve as you learn, but the overall purpose guides your priorities and decisions.

Develop the Scope: Draw the Boundaries

This is your what. What will be delivered and what won't, plus the boundaries that keep work focused. Get clear on what's in and out, and why. Note your assumptions and constraints: time, budget, standards, approvals. Map out connections with other projects or systems so nothing falls through the cracks.

This is where your Product Breakdown Structure (PBS) comes in. Think of it as your project's family tree, mapping out all the deliverables, components, and outputs you'll create. It's like sketching the blueprint before you worry about how to build it. The PBS helps you visualise everything that needs to be delivered. It's about the what, not the how.

Example: Metro line upgrade might include new track sections and platform extensions, but exclude train interiors or station retail areas. Your PBS starts with "Metro Line Upgrade" at the top, branches into "Track Renewal" and "Platform Works," then breaks those down into components like "Rails," "Sleepers," "Ballast" for track, and "Surface," "Edge Protection," "Drainage" for platforms.

In waterfall, scope becomes your baseline with formal change control. In agile, you still set boundaries, but you re-order work based on what's most valuable, using feedback, risks, and team capacity within fixed timeframes.

Define Requirements: From Idea to Reality

This is where you define how well things need to be done. The clear criteria each deliverable must meet so the project actually achieves its benefits.

Now you take your PBS and create your Work Breakdown Structure (WBS). If PBS told you what needs to be built, WBS tells you how you'll build it, the actual work packages and activities. You take each deliverable from your PBS and break it into the work needed to create it. Moving from "we need new track" to "remove old rails, prepare trackbed, lay sleepers, install rails."

Example: Your PBS showed "Track Renewal" as a component. Your WBS breaks this down into the actual work packages: remove old rails, prepare trackbed, lay new sleepers, install new rails, weld joints, test and commission. Each component from your PBS gets broken into these executable work packages.

PBS makes sure you don't forget what needs to be built. WBS makes sure you don't forget what work needs doing. Together, they give you the full picture. What you're delivering and how you'll actually deliver it.

A simple scope management process

Monitor and Control: Protect the Plan

This is about keeping the project on track and handling changes deliberately. Use your agreed objectives, scope, and requirements as reference points. Monitor progress, assess change requests, and decide whether to approve based on impact to time, cost, and benefits.

In waterfall, changes go through formal impact assessment and approval. In agile, time and team capacity are fixed, scope flexes by re-ordering the backlog based on what's most important.

The Real-World Bit: People and Politics

Perfect scope is rare. Your baseline is a snapshot created with the information and pressures you had at that moment. That's normal. What matters is making uncertainties explicit. Document assumptions, "to be determined" items, exclusions. And set clear deadlines for clarifying them.

What scope creep actually looks like. It starts with "quick" additions that seem harmless. One extra report, a small feature, a tweak "while we're in the code." Think of it like stuffing "just one more thing" into your suitcase. One becomes five, the zip won't close, and you're paying extra at the gate.

People dynamics matter. Everyone has an agenda. Operations wants minimal disruption. Finance wants lowest cost. Technical teams want the latest kit. The worst one? A stakeholder who waited until we were 80% complete to mention they'd "always assumed" we'd be including something that was explicitly out of scope from day one.

It's the PM's job to protect focus. You're not being difficult, you're protecting value. Useful questions: Does this support our objectives? What's the smallest version that proves value? If we say yes, what won't we do? And sometimes the most important question: "Can you show me where that was agreed?"

The Psychology Behind the Process

Clarity reduces mental load. Clear, visible scope means people can focus on solving problems rather than constantly re-interpreting what's in or out. Use simple visuals such as one-pagers, diagrams. Make scope easy to understand. We once turned a lengthy scope document into a single A3 diagram. The team finally stopped asking the same questions about what was in or out.

Ambiguity creates anxiety. Vague scope makes people fill gaps with assumptions, leading to stress, rework, and conflict. Review and update scope regularly, especially after changes or when new people join. I've seen teams waste weeks because two people had different assumptions about what "user-friendly" meant in the requirements.

First impressions stick. Teams often anchor to the first version of scope, even when new facts suggest it should change. Schedule regular scope reviews to challenge early assumptions. It's like planning a dinner party for 10 people, buying all the food, then finding out half can't make it. But you keep cooking for 10 anyway because that's what you had in your head from the start.

Persuasive voices can derail focus. Strong personalities can sway direction away from evidence or objectives. Link every scope decision back to agreed benefits to protect focus. I've been in meetings where the loudest voice nearly doubled our scope, until we went back to the original business case and asked: "Which of these benefits does this extra work support?" Silence.

Key Takeaways

  • Start with objectives (why), shape scope (what), agree requirements (how well). Keep all three visible and updated.

  • Use PBS to map deliverables, WBS to break them into actual work packages.

  • Treat scope as a living conversation, not a filed document.

  • Change is fine, if it's deliberate, approved, and properly resourced.

  • Challenge confidently when ideas drift from objectives. You're protecting value, not blocking progress.

What traps have you fallen into with scope management? Let's compare notes, drop me a message or connect on LinkedIn. I'm always learning from other people's experiences.

Next up: a simple, visual guide to PBS and WBS. How to sketch them quickly and use them to build plans your team can actually deliver against.

References

Want more practical PM insights like this?

Subscribe to The PM Notebook for regular insights straight to your inbox, or listen to The Real PM Podcast for honest conversations about what actually works.

Ready to bridge theory and practice? Try Mindcast - the first-of-its-kind interactive experiences I developed where you step through real project scenarios and make PM decisions hands-on. It's my way of helping and guiding you beyond traditional learning to build the practical judgment that only comes from doing.

Connect with me on LinkedIn for project management insights or get in touch to share your thoughts and experiences.
